Trade library · Build

General Construction

What the platform does for a general contractor: it tracks a build from permit to certificate of occupancy, with the inspection sequence and the money in view.

General Construction has its own configuration.

Stinger is one system, not a different product per trade. What changes is the configuration it runs on: the words on the screen, the columns on the board, the stages a job moves through, and the rules that decide what comes first. This is the General contractor configuration, as it ships.

The words on the screen

A piece of work is called
Job
An incoming call is called
Inbound lead
The board is called
Pipeline

Job types: New lead, Estimate, Follow-up, Booked.

The columns on your board

  • Draft
  • Ready
  • Booked

An incoming caller is a inbound lead.

The stages a job moves through

  1. Captured
  2. Qualified
  3. Quoted
  4. Approved
  5. Signed
  6. Paid

The rules that decide what comes first

  • Owner approval is required before sending

Set your trade in Settings and this dashboard switches to your industry’s own words, jobs, and pipeline.

How you get it: tell us your trade and we set the configuration up with you during onboarding. See every trade's setup questions side by side.

Config-backed. The three main license classes are carried with citations. Threshold-building and condominium-milestone sequences are also in the config.

Florida licensing classes

General contractor

Unlimited as to the type of work, and may contract for any activity requiring licensure under Part I.

Fla. Stat. 489.105(3)(a)

Building contractor

Commercial and residential buildings not exceeding three stories, plus remodel and repair not affecting structural members.

Fla. Stat. 489.105(3)(b)

Residential contractor

Construction, remodeling, or repair of one-, two-, or three-family residences not exceeding two habitable stories.

Fla. Stat. 489.105(3)(c)

The dashboard layout is shared across every trade. The build stages, job types, permits, and compliance rules below are generated from this trade's own config pack, so they are specific to General Construction.

Build stages and phases

New single-family custom build

  1. Permit
  2. Site
  3. Foundation
  4. Shell
  5. Dry-in
  6. Rough-ins
  7. Inspections
  8. Insulation / drywall
  9. Finishes
  10. Final
  11. CO

How a Florida job clears build

  1. Permit issued by the local enforcing agency
  2. Required inspections, in sequence
  3. Final inspection
  4. Certificate of occupancy or completion

Threshold building - the second inspection calendar build

  1. Structural inspection plan
  2. Special inspector engaged
  3. Structural inspections

Milestone-driven condominium restoration build

  1. Milestone inspection
  2. Engineer's report
  3. Board vote
  4. Member assessment
  5. Restoration scope

Close-out build

  1. Punch list
  2. Permit finalised
  3. CO issued
  4. Lien releases collected
  5. Retainage released

Job types

New single-family custom buildpermit

The longest cycle, the most trades, and the most owner-decision points. Permit, site, foundation, shell, dry-in, rough-ins, inspections, insulation and drywall, finishes, final, CO.

Production / tract residential buildpermit

The same sequence as a custom home, compressed and repeated. Won on schedule discipline, not craft.

Addition build

Structurally the hardest residential work - tying new to existing, matching elevations, and triggering code upgrades in the existing structure.

Whole-house remodel / kitchen / bath build

The highest change-order rate of any job type. The customer lives in the risk.

Commercial tenant improvement (TI) buildpermit

A landlord, a tenant, and a hard opening date. Permit and inspection driven.

Ground-up commercial buildpermit

Threshold-building rules likely engage, which puts a second, independent structural inspection calendar on the job.

Multifamily / condo restoration build

Increasingly driven by milestone inspections: concrete restoration, balcony and railing, waterproofing, envelope. One of the clearest current pipelines in Florida commercial and multifamily construction.

Storm restoration build

Insurance-adjacent work, bound by the deductible, assignment-of-benefits and public-adjuster constraints that apply to an insured property loss.

Disaster / emergency repair build

Dry-in, stabilise, board-up, then permanent scope.

Permits

Permit triggers from the pack. The pack does not name the local permit or its filing window on purpose, so this page does not either. The building department confirms those.

  • Any construction

    Permit required · inspection required · Fla. Stat. 553.79; Florida Building Code Chapter 1 (Administration)

  • A threshold building - greater than three stories or 50 feet in height, or an assembly occupancy classification exceeding 5,000 square feet in area with an occupant content greater than 500 persons

    Permit required · inspection required · Fla. Stat. 553.71(12); 553.79(5)

  • Taking more than 10 percent of the contract price as a deposit on residential real property - which obliges the contractor to apply for permits within 30 days and commence work within 90 days of permit issuance

    Permit required · Fla. Stat. 489.126

Compliance rules

Obligations that fire on a job, from this trade's pack. Items marked as an open question were not fully settled by the research and should be confirmed, not asserted.

  • The code-edition clock state

    Open question How permits in flight are grandfathered across the 8th to 9th Edition transition rests on secondary sources only and was not confirmed against the Florida Building Commission. Defer to the Florida Building Commission and the local building department.

    Florida Building Commission, floridabuilding.org (fetched 26 Aug 2026)

  • Permit before construction state

    Open question How long plan review takes in any named county, what the filing window is, how many days' notice an inspection requires, and what a specific jurisdiction's amendments are were all excluded by the research's own rail and are not knowable from this file. Defer to the local building department.

    Fla. Stat. 553.79; Florida Building Code Chapter 1 (Administration)

  • The inspection sequence, and covering work before it passes state

    Open question Scheduling windows, notice requirements and turnaround are administered by the jurisdiction and are not stated anywhere in this research. Defer to the local building department.

    Fla. Stat. 553.79; Florida Building Code Chapter 1 (Administration)

  • Closing the permit state

    Fla. Stat. 553.79; Florida Building Code Chapter 1 (Administration)

  • Mandatory subcontracting of the named trades state

    Fla. Stat. 489.113(3)

  • Licence category constrains what may be routed, bid or assigned state

    Fla. Stat. 489.105(3)(a)-(c) read with 489.113(2)

  • Unlicensed contracting kills the contract state

    Fla. Stat. 489.128

  • Licence number on every generated artefact state

    Fla. Stat. 489.119(5)(b)-(c)

  • Deposit, permit application and commencement duties state

    Fla. Stat. 489.126

  • Construction Lien Law WARNING TO OWNER state

    Fla. Stat. 713.015

  • Construction Industries Recovery Fund notice state

    Fla. Stat. 489.1425

  • Notice of Commencement before the first inspection state

    Fla. Stat. 713.135

  • Home solicitation three-day cancellation state

    Fla. Stat. 501.025

  • Threshold building: structural inspection plan and special inspector state

    Fla. Stat. 553.71(9), (12); 553.79(5)

  • Milestone inspection on aging condominium and cooperative buildings state

    Open question Whether any coastal variant of the age trigger still applies could not be settled: the 2025 statute text the research read describes a uniform trigger, and repeal of the reported earlier coastal variant was not confirmed. State neither that it exists nor that it does not. Defer to the association's engineer and the AHJ.

    Fla. Stat. 553.899

  • Construction defect limitation and repose state

    Open question These periods have exceptions, tolling arguments and per-claim nuances, and the same bill's amendment to Fla. Stat. 553.84 was not researched at all. State the framework; never apply it to a specific claim. Defer to counsel.

    Fla. Stat. 95.11(3)(c) as amended by SB 360 (2023), signed 13 April 2023

  • Record retention to the repose window industrytrade convention

  • Continuous load path and the envelope state

  • Construction lien law is the payment-security spine state

    Fla. Stat. Ch. 713

  • Public work substitutes bonds for lien rights state

    Open question The thresholds and notice deadlines under this section were not researched. Do not state one. Defer to counsel.

    Fla. Stat. 255.05

  • Workers' compensation in the construction industry state

    Fla. Stat. Ch. 440

  • Licensure insurance requirements state

    Open question The current general, building and residential category minimums were not researched. Do not state a number for them. Defer to DBPR and the applicable board rule.

    Fla. Stat. 489.115; Fla. Admin. Code R. 61G4-15.015

  • No waiving or rebating a deductible on an insured loss state

    Fla. Stat. 817.234(7)

  • No assignment of post-loss benefits state

    Fla. Stat. 627.7152(13)

  • No interpreting a policy or advising on coverage state

    Fla. Stat. 489.147(2)(d)

Vocabulary the trade actually uses

  • dry-in
  • rough-in
  • top out
  • punch list
  • substantial completion
  • CO / TCO
  • AHJ
  • RFI
  • submittal
  • change order
  • draw
  • retainage
  • NTO
  • NOC

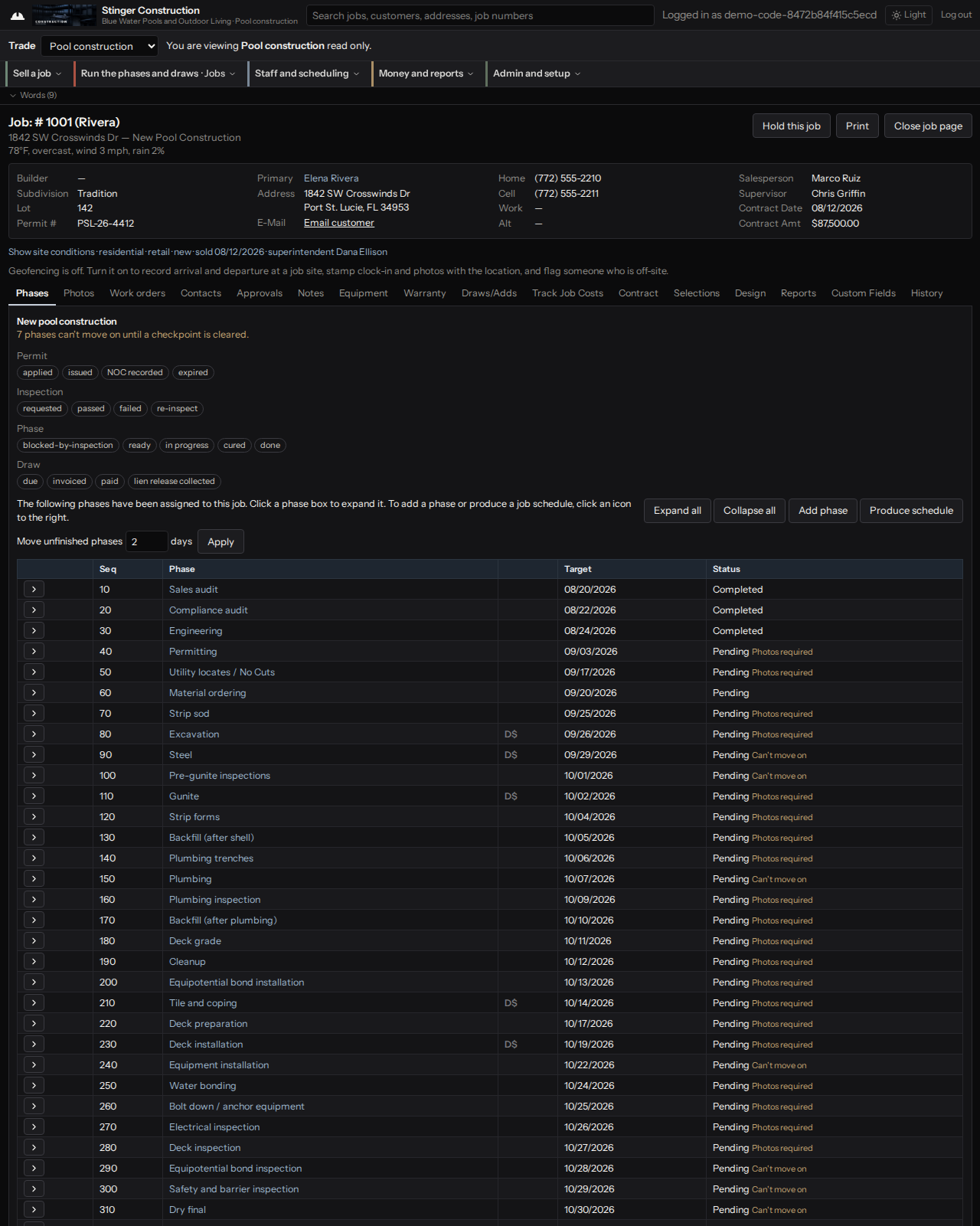

The shared Construction tools show the Rivera job phases, statuses and photo requirements in the pool-business example. Check the phase row before advancing the build so any required evidence or hold is visible.
The shared Construction tools show the Rivera job phases, statuses and photo requirements in the pool-business example. Check the phase row before advancing the build so any required evidence or hold is visible.

The captures above are a pool construction job, shown as an example of the shared Construction workspace. The build screens are the same across trades; what changes for general construction is the licensing, stage sequence, and vocabulary on this page, not the screen layout.

Config-backed for licensing, stages, and vocabulary. General construction runs on the shared build and command screens. Pool construction is the one build vertical with its own hard-themed screen set.
